Data Center Record.
UT · Spanish Fork

Volition Industries Spanish Fork

Volition Industries proposes to convert the former Fingerhut warehouse at the mouth of Spanish Fork Canyon into a self powered data center running on natural gas fuel cells, pending Spanish Fork City Council amendments to Title 15.

Status
proposed
Developer
Volition Industries
Capacity
250 MW
County
Utah County
Use
AI, type not stated
Tenancy
Not disclosed
First recorded
September 4, 2026
Last verified
September 5, 2026

The site

Colors show how each state treats data centers, from open to closed, based on the rules its counties and cities have passed. A state takes the color of its strictest rule. Grey means we have records there but no rule yet.

Pins are projects. The color says where each one stands, from rumored to running; the size says how much power it would use, where that has been disclosed. A hollow pin means we know the town but not the exact site.

Tap a state to see its counties and projects. Tap a pin for the quick facts, and tap again to open its full record.

Details
Rating scale
  • Open green
  • Case by case yellow
  • Restrictive orange
  • Closed red
  • No published rating

A state's rating is the most restrictive published jurisdiction rating in the state. Ratings sit on the jurisdictions themselves in the state view. A county or city shaded grey has at least one record.

Status enum
  • rumored rumored
  • proposed proposed
  • waiting on permits permitting
  • approved approved
  • being built under_construction
  • running operational
  • stalled stalled
  • cancelled cancelled
  • approximate location (city or county centroid)

Pin radius is 7 pixels where capacity is not disclosed, and scales from 7 to 18 pixels between 0 and 1,000 MW where it is.

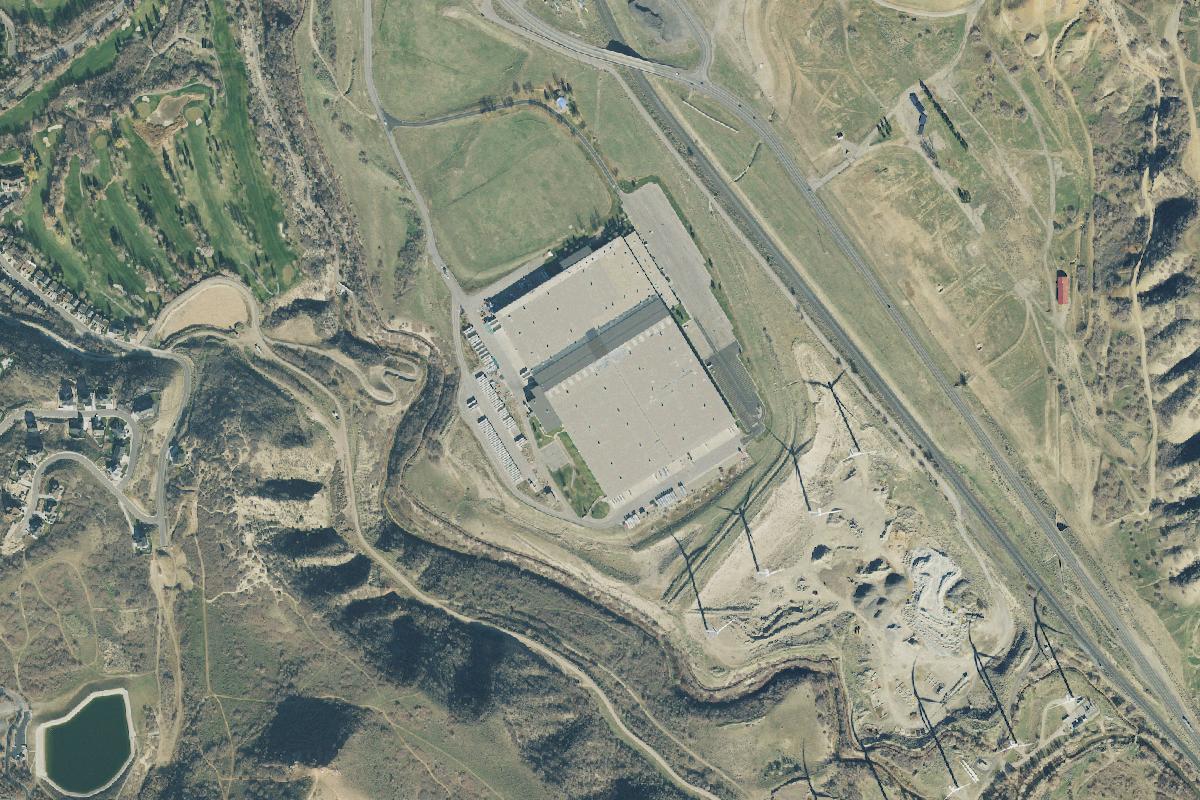

This site
  • the record's location
  • parcel outline, from the county parcel record
  • county boundary

Other pins are the published projects in the same state. The imagery beneath is the USGS national orthoimagery, public domain, shown so the land around the site can be read.

Location precision
parcel
Parcel
672280003, 4000 E HWY 6
Nearest homes
0.27 mi (434 m) to a Census block with 14 housing units

Parcel outline from the county parcel record as published through services1.arcgis.com, retrieved 2026-09-05. The distance to homes is the shortest line from the record's coordinates to the boundary of the nearest 2020 Census block with at least one housing unit, computed 2026-09-05; how it is computed. Other pins are the published projects in UT; tap one for its summary.

Disclosed figures

FigureValueBasisSource
Capacity 250 MW developer estimate heraldextra.com
Water 685 gallons per day developer estimate heraldextra.com
Noise Not disclosed not disclosed
Permanent jobs Not disclosed not disclosed
Annual tax 40,000,000 developer estimate heraldextra.com

Each figure carries the basis its source gave. A developer estimate is what the company said; a permitted figure is what a permit allows; a measured figure was observed. Nothing here is estimated by the Record. Water is recorded in gallons per day; where a source states an annual figure it is divided by 365 and the source is linked.

What it is for and whom it serves

  • AI, type not stated Share not disclosed ksl.com

Tenants, tenancy and local service commitments: not disclosed.

Status history

  1. September 1, 2026 proposed

    The project is proposed under the status rule adopted 2026-09-05: it is waiting on the Title 15 text amendment before it can apply, and no application in its name is on file. On September 1 the City Council delayed the Title 15 vote a second time and Volition Industries said it may take the project to another community. Source · local outlet

  2. September 1, 2026 waiting on permits

    Spanish Fork City Council delayed the Title 15 vote a second time, for two more weeks, and Volition Industries said it may take the project to another community. Source · local outlet

  3. August 25, 2026 waiting on permits

    Mayor Mike Mendenhall posted on Facebook that he supports the proposal, citing the tax revenue and jobs the company has described. Source · local outlet

  4. August 18, 2026 waiting on permits

    After a public hearing of more than six hours, Spanish Fork City Council tabled the Title 15 amendments the project depends on until September 1. Source · local outlet

  5. August 14, 2026 proposed

    Volition Industries held a public open house on the proposal at the Spanish Fork Library. Source · local outlet

  6. April 21, 2026 proposed

    Volition Industries presented a self powered data center at the former Fingerhut warehouse to the Spanish Fork City Council in a work session. Source · primary source

History is append only. Earlier states are never overwritten, and each entry carries the source it rests on.

Sources

Primary

Reporting

This record as data

The structured fields on this page are released under CC BY 4.0. Cite it as: Data: Data Center Record, datacenterrecord.org, CC BY 4.0, and link to this page.
