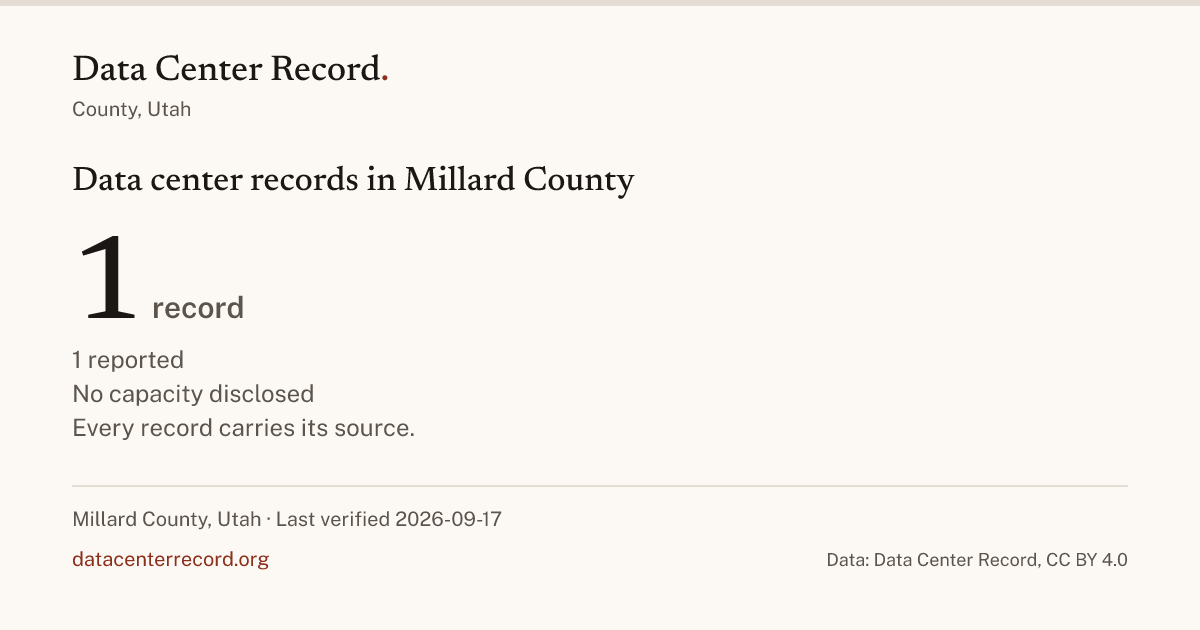

Power, water, jobs and tax, summed only where a data center disclosed the figure; what each facility is for; how each is cooled. Nothing here is estimated.
Power, water, jobs and tax
Summed only where a record disclosed the figure; a record with no figure adds nothing and is counted as not disclosed. Water is summed per day and per year separately, as the sources stated it, and never converted. A tax claim given as a range is summed at both ends.
By what the facilities are for
A record that lists several uses counts once under each. Each cell is the sum over the records with that use, disclosed rows only.
Third party figures on the same metrics Numbers from outside sources on the same metric and place. A figure a project disclosed about itself is in the sums above, not here. Where several sources give the same figure for the same place and year, it is one row with every source behind it (84 sources on 65 rows).
Power
9 GW Box Elder County, UT, 2026 6 sources 250 to 400 MW Spanish Fork, Utah County, UT, 2026 3 sources The proposed Volition project would be a billion dollar, self powered data center that would generate between 250 and 400 megawatts of its own power using natural gas. FOX 13 News Utah (fox13now.com) The proposed data center would generate 250 to 400 megawatts of power using natural gas. YouTube (youtube.com) The proposed Volition data center would generate between 250 and 400 megawatts of its own power using natural gas. KSL News (ksl.com) 600 MW Beaver County, UT, 2026 3 sources 396 MW Beaver County, UT, 2026 3 sources 10 GW Millard County Data Center , Delta, Millard County, UT, 20262 sources 400 MW Utah, statewide, 2026 2 sources 250 MW Spanish Fork, Utah County, UT, 2026 2 sources 16 GW Box Elder County, UT, 2026 Physicist Robert Davies of Utah State University estimated the project could reach 16 gigawatts at full capacity. Yahoo Finance (finance.yahoo.com) 10.4 GW Box Elder County, UT, 2026 New York City uses 10.4 gigawatts during the hottest summer months. Realtor.com (realtor.com) 9.6 GW Carbon County, UT, 2026 Valar Atomics' Project Beehive reactors would produce around 9.6 gigawatts of power for the data centers in aggregate, according to the company's proposal to federal regulators as NPR reported it. NPR (npr.org) 9.5 GW Box Elder County, UT, 2026 Stratos project plans call for a complex of data centers on 20,000 acres in Hansel Valley with up to 9.5 gigawatts of power generating capacity. KSL (ksl.com) 9 GW Hansel Valley, Box Elder County, UT, 2026 Total project power generating capacity over long haul could be up to 9 gigawatts. KSL.com (ksl.com) 6 GW Millard County Data Center , Delta, Millard County, UT, 2026About 6 gigawatts of Delta Gigasite capacity expected from solar energy. Utah News Dispatch (utahnewsdispatch.com) 6 GW Box Elder County, UT, 2026 Loudoun County data centers combined use 6 gigawatts of power. KSL.com (ksl.com) 4 GW Utah, 2026 The approximate total electric power used by the entire state of Utah is 4 gigawatts. YouTube (youtube.com) 4 GW Beaver County, UT, 2026 United States has just over 4 gigawatts of installed geothermal capacity. YouTube (youtube.com) 4 GW Box Elder County, UT, 2026 Kevin O'Leary stated the entire state of Utah consumes about 4 gigawatts of power over the course of a year. Deseret News (deseret.com) 3 GW Box Elder County, UT, 2026 Phase 1 of the project requires 3 gigawatts of power. YouTube (youtube.com) 2.1 GW Millard County Data Center , Delta, Millard County, UT, 2026About 2.1 gigawatts of Delta Gigasite capacity expected from natural gas generation. Utah News Dispatch (utahnewsdispatch.com) 2 GW Beaver County, UT, 2026 Fervo is permitted for up to 2 gigawatts at Cape Station site. datacenterrichness.substack.com (datacenterrichness.substack.com) 1.8 GW Millard County Data Center , Delta, Millard County, UT, 2026About 1.8 gigawatts of Delta Gigasite capacity expected from Intermountain Power Project. Utah News Dispatch (utahnewsdispatch.com) 1.5 GW Box Elder County, UT, 2026 The first phase of power generation for the Stratos Project will be limited to 1.5 gigawatts, as O'Leary Digital's chief executive described the updated plans. KSL (ksl.com) 1.5 GW Hansel Valley, Box Elder County, UT, 2026 First phase of power generation element limited to 1.5 gigawatts. KSL.com (ksl.com) 1,085 MW Utah, statewide, 2026 Virginia already has 7 large data center sites with a capacity of 1,085 megawatts. Cache Valley Daily (cachevalleydaily.com) 1 GW Beaver County, UT, 2026 Combined power commitment could reach nearly 1 gigawatt. Data Center Richness | Substack (datacenterrichness.substack.com) 658 MW Beaver County, UT, 2026 Fervo existing power contracts pipeline with Google, Shell, and SCE totals 658 megawatts. YouTube (youtube.com) 396 MW Beaver County, Utah, UT, 2026 The PPA is said to be the world's largest enhanced geothermal PPA to date at 396MW. finance.yahoo.com (finance.yahoo.com) 100 MW Beaver County, UT, 2026 Fervo anticipates bringing Phase 1 to 100 megawatts in early 2027. YouTube (youtube.com) 33 MW Beaver County, UT, 2026 Fervo plans to bring 33 megawatts online in Q4 using modular systems called GeoBlocks. YouTube (youtube.com) 3 MW Beaver County, UT, 2026 Fervo has 3 megawatts of active geothermal power generation from Project Red in Nevada. YouTube (youtube.com) 2 acres Millard County Data Center , Delta, Millard County, UT, 2026Water consumption at Delta Gigasite will be 2 acre feet per 100 megawatts per year with a closed loop cooling system, totaling up to 200 acre feet per full build out. constructionreviewonline.com (constructionreviewonline.com) 175 MW West Jordan, Utah County, UT, 2025 Completed campus will have more than 1 million sq ft of data centers with 175 MW combined capacity. enr.com (enr.com) 1 GW West Jordan, Salt Lake County, UT, 2022 Novva long term goal to deploy up to 1 gigawatt capacity by 2027. Data Center Frontier (datacenterfrontier.com) 6 GW Iron County, UT, 2021 Facebook has contracts for more than 6GW of wind and solar energy across 18 states and five countries with 63+ projects. Data Center Dynamics (datacenterdynamics.com) 814 MW Iron County, UT, 2021 Facebook's total solar investments in Utah are 814MW. Data Center Dynamics (datacenterdynamics.com) 235 MW Iron County, UT, 2021 In September, Facebook bought 235MW of solar power in Utah from Rocky Mountain Power. Data Center Dynamics (datacenterdynamics.com) 120 MW Iron County, UT, 2021 Appaloosa solar project is 120MW. Data Center Dynamics (datacenterdynamics.com) Water, stated per day
900,000 gallons a day Hansel Valley, Box Elder County, UT, 2026 At full buildout, project will consume under 900000 gallons of water a day on average after recycling. KSL.com (ksl.com) Permanent jobs
2,000 jobs Box Elder County, UT, 2026 3 sources 2,000 to 4,000 jobs Box Elder County, UT, 2026 Brookings research found counties hosting major data centers can see overall employment rise by roughly 2,000 to 4,000 jobs after several years. KUTV (kutv.com) 4 to 5 percent Box Elder County, UT, 2026 Brookings research on 770 data centers found when a county gets its first data center, total private employment rises by 4 to 5 percent. KUTV (kutv.com) 4 to 5 percent Utah, statewide, 2026 A Brookings Institution study of more than 700 data centers nationwide found that counties receiving their first large data center experienced a 4 to 5 percent increase in total private employment over five to six years. Cache Valley Daily (cachevalleydaily.com) 162,148 dollars per job per year Millard County Data Center , Delta, Millard County, UT, 2026Average annual salary at Delta Gigasite about 162,148 dollars per job. Utah News Dispatch (utahnewsdispatch.com) 1,200 jobs Eagle Mountain, Utah County, UT, 2026 Expansion to bring 1,200 construction jobs at peak. KUTV (kutv.com) 300 jobs Eagle Mountain, Utah County, UT, 2026 Expansion to bring more than 300 jobs once complete. KUTV (kutv.com) 106 jobs Utah, 2026 State officials estimate 106 jobs per data center. Deseret News (ksl.com) 22 percent Box Elder County, UT, 2026 Brookings research found information sector employment rises by 22 percent when a county sees its first data center. KUTV (kutv.com) 11 percent Box Elder County, UT, 2026 Brookings research found construction employment rises by 11 percent when a county sees its first data center. KUTV (kutv.com) 4 percent Utah, statewide, 2026 Studies have found total private employment rising roughly 4% to 5% over five to six years, while wages for existing employees and new hires increased approximately 3% to 4%. KUTV (kutv.com) 1,500 employees Eagle Mountain, Utah County, UT, 2022 Mortenson Construction had around 1,500 employees at the location. KUTV (kutv.com) Tax each year
4,000,000,000 USD Spanish Fork, Utah County, UT, 2026 2 sources 2,000,000,000 USD Utah, statewide, 2026 2 sources Hypothetical $2 billion data center with $1.5 billion worth of personal property can substantially reduce tax rate of counties during first year. Utah News Dispatch (utahnewsdispatch.com) Research from the Kem C. Gardner Policy Institute at the University of Utah found that a $2 billion data center could represent more than 20% of the existing property tax base in 21 Utah counties. Cache Valley Daily (cachevalleydaily.com) 44,000,000 USD Spanish Fork, Utah County, UT, 2026 2 sources Volition said the facility would generate around $44 million in tax revenue for the city, school district and taxing entities. KSL News (ksl.com) Chavez stated Volition would generate around $44 million in annual tax revenue for the city, school district and other taxing entities. KSL.com (ksl.com) 830,000 to 1,900,000,000 dollars Utah, statewide, 2026 A Good Jobs First report says states that do disclose data center tax exemption costs showed revenue losses ranging from $830,000 to $1.9 billion in 2025. Yahoo (yahoo.com) 4,500 to 8,900 dollars per household per year UT, 2026 One gigawatt AI data center could generate enough tax revenue for $4,500 to $8,900 annual households dividends. Fox News (foxnews.com) 2,500,000,000 dollars Utah, statewide, 2026 Georgia is projected to lose 2.5 billion dollars in sales tax revenue from data center incentives in 2026. KUTV (kutv.com) 1,900,000,000 dollars Utah, statewide, 2026 Virginia lost 1.9 billion dollars in sales tax revenue from data center incentives in one year. KUTV (kutv.com) 1,500,000,000 dollars Utah, statewide, 2026 Ohio lost more than 1.5 billion dollars in sales tax revenue in 2025 from data center incentives. KUTV (kutv.com) 1,300,000,000 dollars Utah, statewide, 2026 Texas lost 1.3 billion dollars in sales tax revenue from data center incentives. KUTV (kutv.com) 172,000,000 dollars Millard County Data Center , Delta, Millard County, UT, 2026Tax credit will save the company about 172 million dollars in taxes over 20 years. News From The States (newsfromthestates.com) 100,000,000 dollars per year Box Elder County, UT, 2026 Stratos project promised more than 100 million dollars in annual tax revenue to Box Elder County at full capacity. KSL.com (ksl.com) 40,000,000 USD Spanish Fork, Utah County, UT, 2026 Combined property taxes are estimated at about $40 million with the largest flow going into Nebo School District. The Cougar Chronicle (thecougarchronicle.com) 750,000,000 dollars Eagle Mountain, Utah County, UT, 2022 Local and state tax breaks could be worth up to $750 million over several decades. W.Media (w.media) What the facilities are for No source on file states what any of the 1 tracked facility in Millard County is for.
How the facilities are cooled No source on file states how any of the 1 tracked facility in Millard County is cooled.
