Sources on this page
Every number on this page comes from a named source. Click any source to open the document in a new tab.
If a link has moved or a document has changed, let us know and we will update the record and log the change.
Last verified: · 80 reporting sources

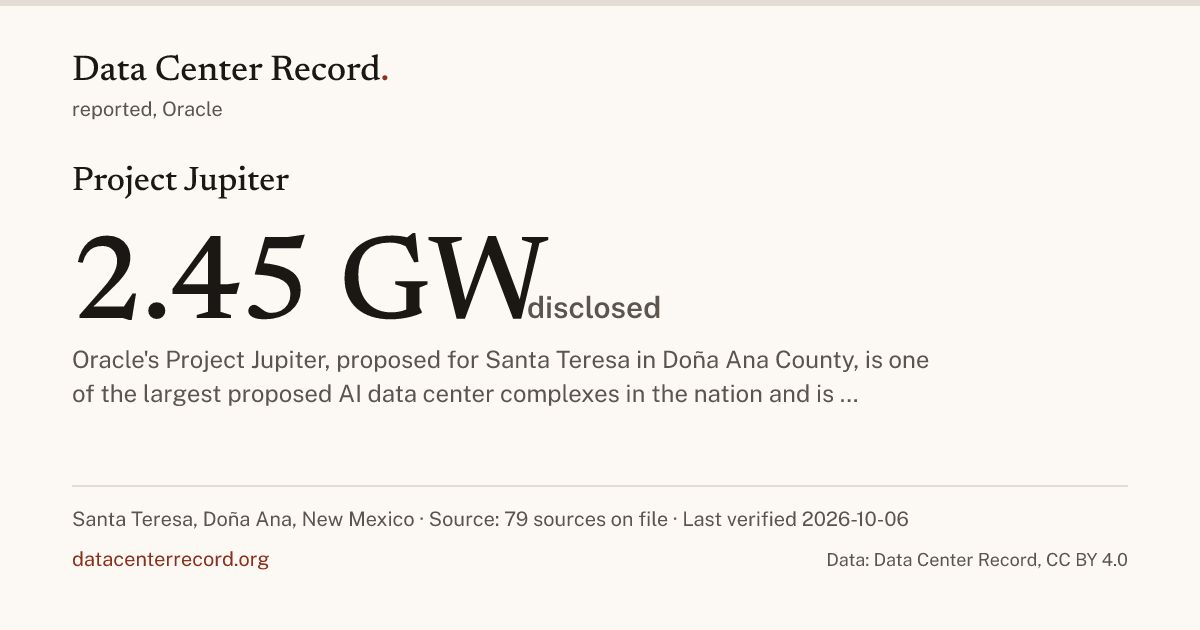

Oracle's Project Jupiter, proposed for Santa Teresa in Doña Ana County, is one of the largest proposed AI data center complexes in the nation and is stalled in permitting amid New Mexico Supreme Court stays on water and air quality permits and broad community opposition. [3] Oracle reported that construction on Project Jupiter data center campus is moving quickly with strong progress on site, and will achieve 100% carbon free energy matching by 2031. [3]
How much power it needs and how much water it would use have not been disclosed.
Connected government officials, corporate entities, utilities and local rules on the public record.
connecting to the utility would violate the IRB unless it were amended(October 27, 2026) abqjournal.com (opens in a new tab)
I'm really concerned for the future here in my home, a place that is so arid and so dry already. As an artist, AI really concerns me in that aspect as well. It's been taking a lot of creative work from people who have grown up here.(October 27, 2026) abqjournal.com (opens in a new tab)
We've never had a national climate law passed by Congress. And so what we've had in this country are primarily state and local efforts(October 16, 2026) thecooldown.com (opens in a new tab)
going to undo a lot of the very expensive and very meaningful work a lot of people are doing(October 16, 2026) thecooldown.com (opens in a new tab)
View all 55 statements on the record in New Mexico →
Citizen privacy standard: Elected officials, corporate applicants and utility executives are named in full. Private residents who speak at public comment are cited as Resident First L. unless they hold public office or speak on behalf of an organization.
Disclosed engineering ceilings, reported actuals and primary regulatory basis for Project Jupiter.
| Field / Parameter | Disclosed Ceiling | Reported Actual | Basis & Primary Source |
|---|---|---|---|
| Electrical Capacity (MW) | |||
| Site Footprint (Acres) | |||
| Data Hall Buildings | |||
| Cooling & Water System | |||
| Backup Diesel / Gas Generators | |||
| Tax Abatement & Annual Revenue |
Blank cell: not disclosed by any source on file.
The record adds each the day a source gives it. Why these documents.
Chronological regulatory, corporate and permitting events on the record, newest first.
· Status: proposed (content date)
Oracle reported that construction on Project Jupiter data center campus is moving quickly with strong progress on site, and will achieve 100% carbon free energy matching by 2031.
finance.yahoo.com (opens in a new tab) national outlet
(content date)
Oracle issued a force majeure notice to STACK Infrastructure on September 24, allowing it to protect itself contractually if Project Jupiter fails to launch as planned in 2028
(source date; the content gives no date of its own)
A natural gas pipeline needed for the facility has faced delays after permit denials
(source date; the content gives no date of its own)
Oracle sent a contractual notice tied to Project Jupiter seeking protection if construction delays disrupt its 2028 target
(source date; the content gives no date of its own)
Oracle sent a force majeure notice to Blue Owl Capital unit seeking to delay payments if data center fails to come online in 2028
(source date; the content gives no date of its own)
Energy Transfer pipeline delayed to February 1, 2027 after regulatory denials.
(source date; the content gives no date of its own)
Project planned to come online in 2028.
(source date; the content gives no date of its own)
Oracle sent force majeure notice to Blue Owl Capital on Project Jupiter after energy permit denial and pipeline delay.
(source date; the content gives no date of its own)
Oracle says Project Jupiter construction remains on schedule despite force majeure notice.
(source date; the content gives no date of its own)
Oracle declared force majeure over possible power delays to Project Jupiter data center in New Mexico to delay transition to higher rent payments.
[49] fool.com, also Межа. Новини України. (opens in a new tab) international outlet
(source date; the content gives no date of its own)
Increased scrutiny followed by denial of a key permit raised questions about whether the data center will come online as planned
(source date; the content gives no date of its own)
Oracle sent Blue Owl a force majeure notice about Project Jupiter data center in New Mexico
(source date; the content gives no date of its own)
Green Chile pipeline was delayed from August 2026 target to February 2027 after New Mexico State Land Office denied right of way permits.
(source date; the content gives no date of its own)
Oracle issued a force majeure notice to Blue Owl, the project developer unit, due to facility delays relative to the 2028 launch date.
(source date; the content gives no date of its own)
Project Jupiter's Green Chile natural gas pipeline was delayed from August 2026 to February 2027.
(source date; the content gives no date of its own)
Project Jupiter has a 2028 launch date target.
(source date; the content gives no date of its own)
Oracle sent a force majeure notice to Project Jupiter's developer in New Mexico.
(source date; the content gives no date of its own)
Oracle sends force majeure notice on Project Jupiter data center in New Mexico
(source date; the content gives no date of its own)
Oracle sent force majeure notice to Blue Owl Capital seeking payment deferral if project misses 2028 deadline
(source date; the content gives no date of its own)
Oracle announced as tenant of Project Jupiter in January 2026
(source date; the content gives no date of its own)
Oracle issued Request for Proposals to develop 2GW of renewable energy capacity in New Mexico for Project Jupiter
(source date; the content gives no date of its own)
Natural gas pipeline extension rejected by state officials in July 2026
(source date; the content gives no date of its own)
Project has faced denial of key permit amid growing public backlash over power demands and local impacts of massive data centers
(source date; the content gives no date of its own)
Oracle invoked force majeure provision to delay payments if Project Jupiter is delayed and facility does not come online in 2028
(source date; the content gives no date of its own)
Oracle issued force majeure notice to Project Jupiter developers
(source date; the content gives no date of its own)
Project Jupiter was scheduled to come online in 2028.
(source date; the content gives no date of its own)
Oracle sent a force majeure notice to the developer building Project Jupiter due to regulatory hurdles and local opposition.
(source date; the content gives no date of its own)
Natural gas pipeline needed for facility has faced delays after permit denials
(source date; the content gives no date of its own)
Project Jupiter data center in New Mexico targeting 2028 completion
(source date; the content gives no date of its own)
Oracle seeks to defer payments if Project Jupiter fails to come online in 2028 as planned
(source date; the content gives no date of its own)
New Mexico Supreme Court let permitting resume on September 17, 2026
(source date; the content gives no date of its own)
Gas pipeline serving site has twice been denied a state land crossing
(source date; the content gives no date of its own)
Natural gas pipeline to serve campus has faced delays and legal challenges involving water and air quality permits
(source date; the content gives no date of its own)
New Mexico Supreme Court stayed air permit proceeding for proposed microgrid serving campus on Sept. 14
(source date; the content gives no date of its own)
Oracle sends force majeure notice seeking to defer payments if project delays beyond 2028 opening
(source date; the content gives no date of its own)
Oracle data center delay reported in mid day stock market news
(source date; the content gives no date of its own)
Oracle issued force majeure notice on major data center project in New Mexico where it is primary tenant
(source date; the content gives no date of its own)
Oracle sent force majeure notice to Project Jupiter developer seeking to delay payments if data center misses 2028 operational target
(source date; the content gives no date of its own)
New Mexico Office of the State Engineer authorized emergency drilling in October 2025
(source date; the content gives no date of its own)
S&P downgraded Oracle in July, leaving its corporate rating one notch above junk
Moratorium (source date; the content gives no date of its own)
Haaland said her moratorium would not affect Project Jupiter, the Oracle- and OpenAI backed artificial intelligence data center campus under construction at the Santa Teresa Industrial Park.
Moratorium (source date; the content gives no date of its own)
Haaland's moratorium would not affect Project Jupiter, the Oracle- and OpenAI backed artificial intelligence data center campus under construction at the Santa Teresa Industrial Park.
Moratorium (source date; the content gives no date of its own)
Court unpaused regulatory proceedings that had been frozen since August, allowing air quality permit hearing to move forward
(source date; the content gives no date of its own)
Court lifted stay imposed on August 23 that had paused air permit proceeding and water use for Project Jupiter
· reported (source date; the content gives no date of its own)
New tensions flared over Project Jupiter data center in southern New Mexico
the record's rules: the sentence copied its source, was about its headline or carried a number the card's facts do not; written again from the card's facts, on the editor's word
the record's rules: the sentence copied its source, was about its headline or carried a number the card's facts do not; written again from the card's facts, on the editor's word
the record's rules: the sentence was the source's wording or carried a number not in the card's facts; written again from the article
The capacity read 2.45 MW. The source gave 2.45 gigawatts, and the approval of September 25, 2026 wrote the number without its unit. Corrected to 2,450 MW from the same source.
The source was labeled with the Google News search that found it; it now carries its outlet's tier (the record's rules of September 23, 2026). The link did not change.
The source was labeled with the Google News search that found it; it now carries its outlet's tier (the record's rules of September 23, 2026). The link did not change.
The source was labeled with the Google News search that found it; it now carries its outlet's tier (the record's rules of September 23, 2026). The link did not change.
The source was labeled with the Google News search that found it; it now carries its outlet's tier (the record's rules of September 23, 2026). The link did not change.
The source was labeled with the Google News search that found it; it now carries its outlet's tier (the record's rules of September 23, 2026). The link did not change.
The source was labeled with the Google News search that found it; it now carries its outlet's tier (the record's rules of September 23, 2026). The link did not change.
The source was labeled with the Google News search that found it; it now carries its outlet's tier (the record's rules of September 23, 2026). The link did not change.
The source was labeled with the Google News search that found it; it now carries its outlet's tier (the record's rules of September 23, 2026). The link did not change.
The source was labeled with the Google News search that found it; it now carries its outlet's tier (the record's rules of September 23, 2026). The link did not change.
The source was labeled with the Google News search that found it; it now carries its outlet's tier (the record's rules of September 23, 2026). The link did not change.
The source was labeled with the Google News search that found it; it now carries its outlet's tier (the record's rules of September 23, 2026). The link did not change.
Every correction on the record is on the corrections page.
Nearest records are not computed for a record placed at a county seat. Browse all data centers in New Mexico.
Seeking Alpha, Sep 24, 2026; Investing.com, Sep 24, 2026; Yahoo Finance, Sep 24, 2026
Answered directly from the verified filings and local actions on this page.
Oracle is the developer. No construction contractor is named on the record yet.
The named tenant is OpenAI. No promise to the community is on the record.
Power: not disclosed by any source on file. Water: not disclosed by any source on file.
It is proposed, since October 19, 2026. The newest entry, October 19, 2026: Oracle reported that construction on Project Jupiter data center campus is moving quickly with strong progress on site, and will achieve 100% carbon free energy matching by 2031.
Not disclosed by any source on file: how much power it needs, how much water it would use, how loud it would be, jobs once it runs, tax it would pay each year, who is constructing it, how much land, buildings, grid connection, how it is cooled. No missing primary document is listed for this record yet; What the record lacks is where one appears when a person names it.
80 sources on file.
This site is in the WECC Southwest (AZNM) regional power market.
Every number on this page comes from a named source. Click any source to open the document in a new tab.
If a link has moved or a document has changed, let us know and we will update the record and log the change.
Every record on this page carries its sources and the date it was last verified. When you cite it in a story, a study or a public filing, link to this page and give the date you accessed it.
Data Center Record. Project Jupiter. Last verified October 19, 2026. https://datacenterrecord.org/projects/project-jupiter-santa-teresa-nm. Accessed November 22, 2026.
Every row on this page is available to download with its source, its basis and the date it was last verified.
Download this page's records (CSV) JSON
Licensed CC BY-NC 4.0. Say where it came from and do not sell it or use it to train a commercial model without a license.
Free to use and republish with attribution for reporting, research, teaching and public filings under CC BY-NC 4.0. Commercial, enterprise, financial or AI training use needs a commercial license.
Data Center Record takes no money from data center developers, operators, utilities or trade groups. That rule does not change for licensing.
Data Center Record is an independent project and takes no money from data center developers, operators, utilities or trade groups. Reader support keeps the record free to read, with no ads and no paywall.
Last verified , first recorded . Every correction is logged on the corrections page and under What happened. Report a correction · Send a tip about Project Jupiter
Data Center Record, "Project Jupiter", https://datacenterrecord.org/projects/project-jupiter-santa-teresa-nm. Data: Data Center Record, datacenterrecord.org, CC BY-NC 4.0.
The structured rows are CC BY-NC 4.0. Link to this page; that is what turns a reuse into a citation. Commercial use needs a license. Prose stays under copyright.
